Description: COAT-ARM Hastings District Council

Civic Administration Building

Lyndon Road East, Hastings

Phone:  (06) 871 5000

Fax:  (06) 871 5100

WWW.hastingsdc.govt.nz

Open

A G E N D A

Omarunui Refuse Landfill Joint Committee MEETING

Meeting Date:

Friday, 7 December 2018

Time:

1.00pm

Venue:

Council Chamber

Ground Floor

Civic Administration Building

Lyndon Road East

Hastings

Committee Members

Chair: Councillor Heaps

Councillors Lawson, Nixon and Redstone (HDC)

Councillors Dallimore (Deputy Chair) and Tapine (NCC)

NCC Alternate: Mayor Dalton

HDC Alternate: Councillor Kerr

(Quorum = 4 including at least one elected member from each Council)

Officer Responsible

Waste and Data Services Manager, Martin Jarvis

Committee Secretary

Carolyn Hunt (Ext 5634)

HASTINGS DISTRICT COUNCIL

Omarunui Refuse Landfill Joint Committee MEETING

Friday, 7 December 2018

VENUE:

Council Chamber

Ground Floor

Civic Administration Building

Lyndon Road East

Hastings

TIME:

1.00pm (Budget)

A G E N D A

1.         Apologies

An apology from Councillor Kerr has been received.

At the close of the agenda no requests for leave of absence had been received.

2.         Conflict of Interest

Members need to be vigilant to stand aside from decision-making when a conflict arises between their role as a Member of the Council and any private or other external interest they might have.  This note is provided as a reminder to Members to scan the agenda and assess their own private interests and identify where they may have a pecuniary or other conflict of interest, or where there may be perceptions of conflict of interest.

If a Member feels they do have a conflict of interest, they should publicly declare that at the start of the relevant item of business and withdraw from participating in the meeting.  If a Member thinks they may have a conflict of interest, they can seek advice from the General Counsel or the Democratic Support Manager (preferably before the meeting).

It is noted that while Members can seek advice and discuss these matters, the final decision as to whether a conflict exists rests with the member.

3.         Confirmation of Minutes

Minutes of the Omarunui Refuse Landfill Joint Committee Meeting held Friday 5 October 2018.

(Previously circulated)

4.         Health and Safety Management Update                                                               5

5.         Three Month Activity Report                                                                                    7

6.         Additional Business Items

7.         Extraordinary Business Items

8.         Recommendation to Exclude the Public from Items 9, 10 and 11               15

9.         Review of Disposal Fees

10.       Engagement of Tonkin and Taylor for Landfill Consultancy Services

11.       Contract Term Extension - CON2014044 Omarunui Landfill Plant Management

File Ref: 18/1104

REPORT TO:               Omarunui Refuse Landfill Joint Committee

MEETING DATE:        Friday 7 December 2018

FROM:                           Senior Health & Safety Co-ordinator

Nikola Bass

SUBJECT:                    Health and Safety Management Update

1.0       SUMMARY

1.1       The purpose of this report is to update the Committee about Health and Safety Management at the Omarunui Refuse Landfill.

2.0       BACKGROUND

2.1       The Health and Safety at Work Act (HSWA) came into effect on 4 April 2016.

2.2       The HSWA has created a role named specifically under the Act as “Officers”. The Act places a positive duty on ‘Officers’ of an organisation to exercise due diligence to ensure that the organisation complies with its Health and Safety duties and obligations.

2.3       The term “Officers” in the Act includes those who hold positions that enable them to significantly influence the management of the organisation.

2.4       For the purposes of this Joint Committee these roles will be referred to “HSWA Officers” (to assist with differentiating between it and “Council Officers”).

2.5       Due diligence requires HSWA Officers to take reasonable steps to understand the organisation’s operations and Health and Safety risks, and to ensure that they are managed so that Council meets its legal obligations.

3.0       CURRENT SITUATION

3.1       Omarunui Landfill operates under Hastings District Council’s Health and Safety Policy and Procedures

4.0       HEALTH AND SAFETY REPORTING

4.1       Regular reports have been provided to the Joint Committee on a six monthly basis for the last 18 months and there now sufficient history to provide comparative performance moving forward.

4.2       Feedback received during the October Omarunui Refuse Landfill Joint Committee meeting will be adopted with the Health and Safety Management Report being updated to provide comparative analysis with previous data incorporating trending for Lead and Lag indicators.

4.3       Lagging indicators measure an organisation using past incident statistics, for example injury statistics. A leading indicator is a measure preceding or indicating a future event used to drive and measure activities carried out to prevent and control injury or illness. They are focused on future safety performance and continuous improvement, for example personal risk assessments, toolbox talks and audits.  Health and safety reporting is most comprehensive when it encompasses both Lead and Lag Indicators.

4.4       In addition to the six monthly reports, it is recommended that any significant incidents or exceptions continue to be reported quarterly within the operational report.

5.0       SIGNIFICANCE AND ENGAGEMENT

5.1       The Report does not trigger Councils Significance and Engagement Policy and no consultation is required.

6.0       RECOMMENDATIONS AND REASONS

A)        That the report of the Senior Health & Safety Co-ordinator titled Health and Safety Management Update dated 7/12/2018 be received.

Attachments:

There are no attachments for this report.

File Ref: 18/843

1.

REPORT TO:               Omarunui Refuse Landfill Joint Committee

MEETING DATE:        Friday 7 December 2018

FROM:                           Waste and Data Services Manager

Martin Jarvis

Management Accountant

Jeff Tieman

SUBJECT:                    Three Month Activity Report

1.0       SUMMARY

1.1       The purpose of this report is to inform the Omarunui Refuse Landfill Joint Committee on landfill activities for the period ending September 2018.

1.2       This report concludes by recommending it be received.

2.0       financial position

2.1       The financial position of the main accounts at 30 September 2018 is as follows:

$

3 month actuals

$

3 month budget

$

3 month variation

Revenue*

1,493,165

1,450,800

42,365

Expenditure*

937,530

1,115,011

-177,481

Net surplus from operations

555,637

335,789

219,848

*Excludes the waste levy and ETS.

2.2       The net surplus from operations as at 30 September 2018 is $219,848 above budget.  The surplus is partly a result of higher than expected special waste volumes and the programming of expenditure work.

2.3       Tonnages are currently tracking up on last year’s actual total (20,082 tonnes versus 19,939 tonnes).

3.0       revenue

3.1       Total revenue from waste is above budget.  This is mainly due to increased volumes of special waste.

$

3 month actuals

$

3 month budget

$

3 month variation

$

Annual budget

Commercial

725,628

742,500

-16,872

2,970,000

Special

276,786

175,000

101,786

700,000

HDC

181,754

198,000

-16,246

792,000

NCC

267,177

264,000

3,177

1,056,000

Total

1,451,345

1,379,500

71,845

5,518,000

4.0       expenditure

4.1       Expenditure is $175,179 under budget (includes waste levy and ETS) due to some savings in maintenance and external plant hire.

5.0       tonnages

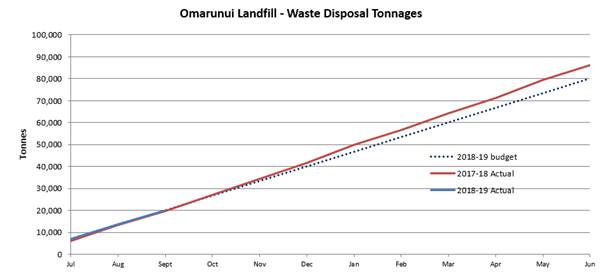

5.1       Overall tonnages year to date are above budget by 82 tonnes or 0.4%.

Activity

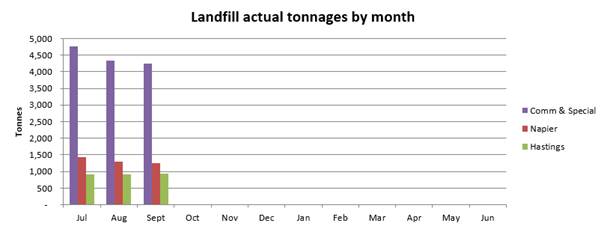

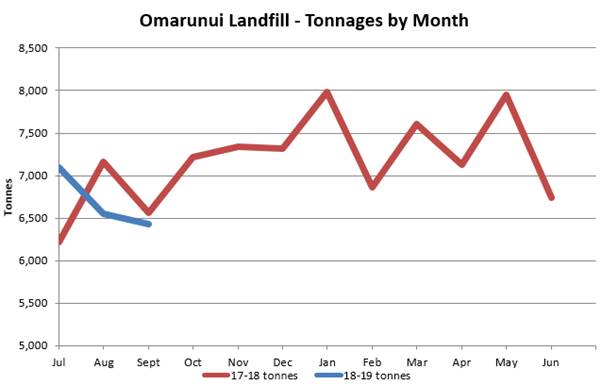

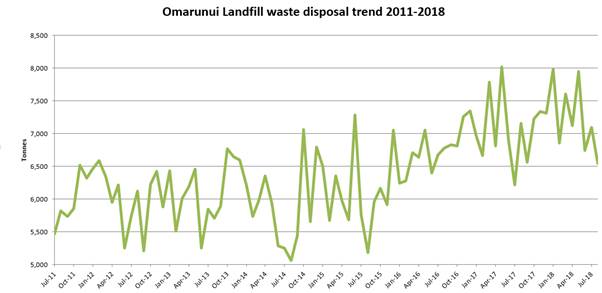

3 month actual

3 month budget

3 month variance

Annual budget

Commercial

10,713

11,250

(537)

45,000 t

Special

2,637

1,750

887

7,000 t

HDC

2,770

3,000

(230)

12,000 t

NCC

3,962

4,000

(38)

16,000 t

Total

20,082

20,000

82

80,000 t

5.2       The budgeted volume of waste for the 2018/19 year is 80,000 tonnes. In 2017/18 the actual volume of waste received was 86,078 tonnes.

6.0       development update for area a & d

6.1       To date $297,961 has been spent on construction work in Stage 3C of Area D.  This work is ongoing mainly involves the construction of gas extraction wells, pipe work and control systems.  A small amount of work relating to earth works and temporary capping has also been undertaken.  The development budget for the full year is $2,424,958.  It is unlikely that this amount will be spent as the extension of Area D liner is now programmed for next financial year.  The funds not spent in the current year will be carried forward to fund the future development stages in Area D.

7.0       development update for area B & C

7.1       To date $102,419 has been spent on planning and design work associated with the future development of the landfill site and in particular the area designated as Area B.  This work has included draft designs as well as options on liner and leachate systems.  Planning work has also been undertaken in preparation for consent work.

8.0       OPERATIONS

8.1       The tip area size has been reduced to a minimum so that operations can run as efficiently as possible.  This also reduces the chance of rubbish blowing away and the amount of “food” available for seagulls to feed on.  Daily cover continues to be excavated from the quarry located in the area known as Area B.  Additional material excavated in this area has been made available for local contractors to use on their construction projects.

9.0       MAINTENANCE WORK

9.1       There are no significant maintenance issues to report.  A lot of maintenance work was carried out last year and no major works are currently planned.  Routine work scheduled in the upcoming months includes the cleaning of the silt ponds.

10.0    leachate

10.1    Due to weather conditions mid-winter a small amount of leachate was carted offsite for disposal.  The cartage stopped as soon as the irrigation system was able to be reactivated.  An additional 20 irrigation pods are planned to be installed this summer.  This extension of the irrigation system will enable the landfill to dispose of a greater volume of leachate.

11.0    LANDFILL GAS

11.1    A total of 20 additional vertical gas wells have been constructed and integrated with the gas collection network.  This has resulted in more gas being captured and further reduced the opportunity of odour escaping into the atmosphere from the compacted rubbish.  The additional landfill gas will in turn provide the “gas to energy” plant with more gas once the “balancing” of the gas field has been completed.

12.0    landfill forest

12.1    The forest harvest was completed in August 2017 with total revenue of $1,644,574 and expenditure of $163,488. The net revenue of $1,481,086 was distributed to the shareholding Councils minus $120,000 which was transferred to a reserve to cover the replanting and maintenance costs.  The replanting has since been completed.

13.0    health and safety

13.1    The Omarunui Landfill operates under the Hastings District Council’s Health and Safety Policy.  The Council’s commitment under this policy is “to keep employees, volunteers, contractors and the community safe through living a strong safety culture”.

13.2    Additional Health & Safety information, and matters relating to the performance of the landfill are the subject of a separate report to this committee.

14.0    efficiencies

14.1    A variety of efficiencies have been achieved over the last five years that have helped keep the gate charges as low as possible.  The landfill will continue to look for operational and developmental efficiencies that will keep Omarunui in this favourable position. Areas that have been looked at to gain efficiencies in include the following:

·     Landfill gas extraction and the implementation of the Tonkin & Taylor recommendations – now completed.

·     Management of the landfill’s obligations under the ETS - ongoing.

·     The access road to the tip face has been shortened.  This has resulted in savings to the landfill and landfill users alike – completed.

·     Efficiencies were gained by minimising the number of times the tip face was moved and keeping the area as small as possible – on-going.

·     Where possible development work has been integrated with operational activities to the benefit of both cost centres.

·     Making maximum use of the area designated for waste disposal – area D extension approved.

15.0    joint hdc/ncc Waste management & minimisation plan

15.1    The following is for the committee’s information as these matters are being overseen by the individual councils and a different joint committee.

15.2    The Joint Waste Management & Minimisation Plan has been adopted by both Councils and staff are working on an implementation plan.  A Waste Management & Minimisation Plan (WMMP) is a requirement of the Waste Minimisation Act 2008 and LGA 2002 in regard to consultation and decision making.

15.3    The joint Plan was formally adopted by the HDC on 30 August 2018 and by the NCC on 18 September 2018.  Staff from both councils are now working on an implementation plan in order to programme and undertake the actions stated in the WMMP.  Changes to the collection systems for refuse and recycling will not come into effect until mid-2020 once existing contracts have expired.

15.4    The vision of the Joint WMMP 2018-2024 is - “to deliver waste minimisation and resource recovery across the Hastings District and Napier City working towards zero waste.”  Amongst other goals and objects there are two targets as follows:

·    20% total tonnage increase in common recyclables diverted from Omarunui Landfill

·    30% total tonnage decrease in organics to Omarunui Landfill

15.5    There is no doubt that the new WMMP will have an impact on the landfill and this is something that needs to be taken into consideration with regard future planning for the site and operation of the site.

16.0    financial summary

16.1    Attached to this report is the financial summary for the 3 month period ending 30 September 2018 (Attachment 1).

17.0    RECOMMENDATION

That the report of the Waste and Data Services Manager, titled “Three Month Activity Report” dated 7 February 2018, be received.

Attachments:

1

Omarunui Landfill Financial summary Sept 2018

CG-14-27-00035

Omarunui Landfill Financial summary Sept 2018

Attachment 1

PDF Creator

PDF Creator

TRIM File No. CG-14-27-00036

HASTINGS DISTRICT COUNCIL

Omarunui Refuse Landfill Joint Committee MEETING

Friday, 7 December 2018

RECOMMENDATION TO EXCLUDE THE PUBLIC

SECTION 48, LOCAL GOVERNMENT OFFICIAL INFORMATION AND MEETINGS ACT 1987

THAT the public now be excluded from the following part of the meeting, namely:

9.         Review of Disposal Fees

10.       Engagement of Tonkin and Taylor for Landfill Consultancy Services

11.       Contract Term Extension - CON2014044 Omarunui Landfill Plant Management

The general subject of the matter to be considered while the public is excluded, the reason for passing this Resolution in relation to the matter and the specific grounds under Section 48 (1) of the Local Government Official Information and Meetings Act 1987 for the passing of this Resolution is as follows:

GENERAL SUBJECT OF EACH MATTER TO BE CONSIDERED

REASON FOR PASSING THIS RESOLUTION IN RELATION TO EACH MATTER, AND

PARTICULAR INTERESTS PROTECTED

GROUND(S) UNDER SECTION 48(1) FOR THE PASSING OF EACH RESOLUTION

9.         Review of Disposal Fees

Section 7 (2) (h)

The withholding of the information is necessary to enable the local authority to carry out, without prejudice or disadvantage, commercial activities.

To enable Council to undertake negotiations.

Section 48(1)(a)(i)

Where the Local Authority is named or specified in the First Schedule to this Act under Section 6 or 7 (except Section 7(2)(f)(i)) of this Act.

10.       Engagement of Tonkin and Taylor for Landfill Consultancy Services

Section 7 (2) (h)

The withholding of the information is necessary to enable the local authority to carry out, without prejudice or disadvantage, commercial activities.

To enable the Committee to undertake negotiations..

Section 48(1)(a)(i)

Where the Local Authority is named or specified in the First Schedule to this Act under Section 6 or 7 (except Section 7(2)(f)(i)) of this Act.

11.       Contract Term Extension - CON2014044 Omarunui Landfill Plant Management

Section 7 (2) (h)

The withholding of the information is necessary to enable the local authority to carry out, without prejudice or disadvantage, commercial activities.

To enable Council to conduct negotiations.

Section 48(1)(a)(i)

Where the Local Authority is named or specified in the First Schedule to this Act under Section 6 or 7 (except Section 7(2)(f)(i)) of this Act.
